More traffic impacts expected on I-70 next year as $700 million Floyd Hill project wraps up its first construction season

The major construction project along Colorado's Interstate 70 mountain corridor aims to relieve congestion and improve safety for drivers

Share this story
Crews set rock and wire on a hillside in October 2023, amid construction on the Interstate 70 Floyd Hill project.
Colorado Department of Transportation/Courtesy photo

After construction began on the Interstate 70 Floyd Hill project this summer, the Colorado Department of Transportation announced that ample progress has been made on the $700 million project, according to a Dec. 27 news release from the transportation department.

The multiyear infrastructure project focuses on an 8-mile stretch of the interstate between Evergreen and eastern Idaho Springs.

Construction on the east section of the project — from County Road 65 to the bottom of Floyd Hill — began in July and is expected to last until summer of 2026, according to the CDOT website. Traffic impacts are expected next year.



In 2023, crews focused on rock scaling and rock blasting to widen I-70 as well as drainage work and building retaining walls, the news release states. There were 66 traffic holds on I-70 and U.S. Highway 40 to perform rock scaling and eight rock blasts, according to the transportation department.

Construction equipment drills into the side of a wall along Interstate 70 in November 2023, during the ongoing Floyd Hill project.
Colorado Department of Transportation/Courtesy photo

To widen the highway, 18,000 tons of material — the equivalent of 3,600 African elephants — was removed from the slope above eastbound I-70 along the east section of the project, where rock blasting is now 90% complete, the release states. Two additional rock blasts are reportedly anticipated for this area in January and early February.



Crews also installed 2,825 linear feet — the length of more than nine football fields — of drainage pipe and built retaining walls enforced with 20,000 square feet of shotcrete, the release states. Shotcrete helps maintain hillsides along the mountain corridor with a natural-looking finish, according to the transportation department.

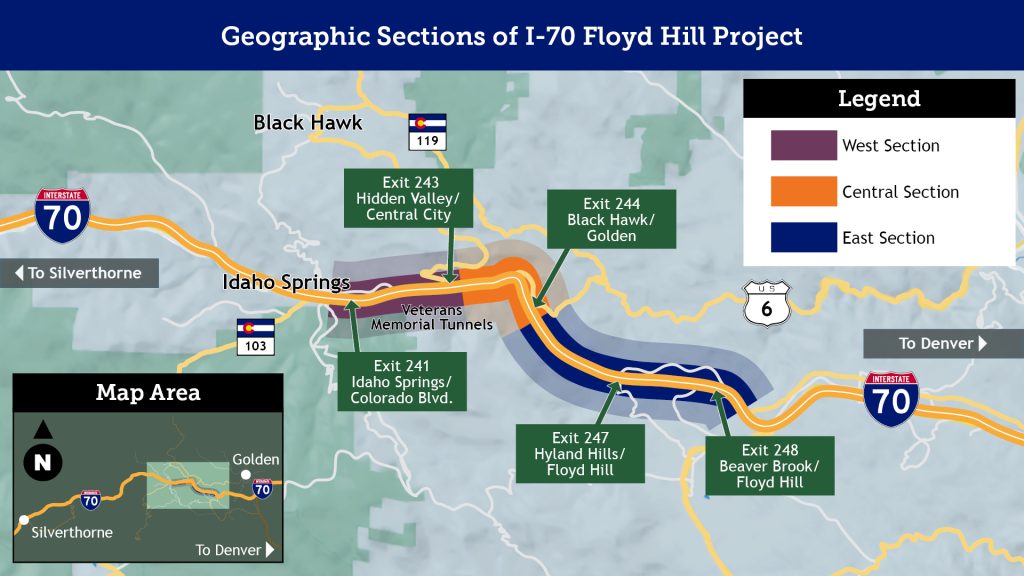

A map shows the three sections of the multi-year Floyd Hill project along Interstate 70.
Colorado Department of Transportation/Courtesy illustration

In late-fall, crews began preconstruction activities in the west and central sections of the project. To prepare for construction, crews in October reportedly relocated the I-70 Mountain Express Lane tolling infrastructure and began utility relocation and grading along the Clear Creek Greenway Trail, which requires a long-term closure of the trail.

Next year, work will continue on the east section of the project with construction activities expanding further west toward Idaho Springs. Early in the year, work will begin in the west section of the project, which spans I-70 from Exit 241 in Idaho Springs to Exit 243 at Hidden Valley, followed by work in the project’s central section, from about Exit 243 to the middle of Floyd Hill near Exit 244, according to the transportation department.

Drivers can expect overnight lane and ramp closures and intermittent daytime traffic holds for rock blasting and rock scaling, the release states. The best way to stay informed of traffic impacts is by signing up for project alerts by texting floydhill — one word, lowercase — to 21000.

Heavy equipment moves soil near the edge of Interstate 70 in August 2023, as work continues on the Floyd Hill project.
Colorado Department of Transportation/Courtesy photo

The I-70 Floyd Hill project will add a third westbound I-70 travel lane — a full-time, tolled Express Lane from just west of Exit 247 through the Veterans Memorial Tunnels to Exit 241 at Idaho Springs — where a two-lane bottleneck now exists, according to the CDOT website.

The website also states that the project will rebuild bridges, improve traffic flow and access at interchanges and intersections, straighten roadway curves to improve sight distance and enhance wildlife connectivity, among other improvements.

Construction on the west section is expected to last until fall 2027, while construction in the central section is expected to last until the end of 2028.
